We try to avoid hyperbole at GDT, but it is now very clear that RTD is experiencing a crisis in terms of the state-of-good-repair of its Light Rail system. A wave of 10mph “slow zones”, imposed after a new track inspection methodology was implemented discovered multiple defects such as “rail burn”, coupled with the coping panels project and downtown light rail reconstruction project have made the published schedule unworkable leading to the E, H and R lines becoming virtually unusable for riders.

What has caused the crisis?

In May 2024, RTD’s Light Rail Maintenance-of-Way (MoW) Department implemented an “enhanced inspection methodology” for its light rail track inspections. This was as a result of an item in Corrective Action Plan CAP02 that was submitted to the Colorado Public Utilities Commission (PUC) as part of RTD’s response to the 19th and Stout Condemned Rail Incident.

The inspections found multiple instances of “rail burn” which we were told at the time lead to the imposition of multiple 10mph “slow zones” until they could be rectified.

“Rail burn” is caused by train wheels slipping as they accelerate. It is not an age related defect and can therefore be present on newly laid track as much as track that is 30 years old. If left untreated “rail burn”, acts like that chip in your car’s windshield – it will lead to cracks and eventually your windshield (rail) will shatter completely with potentially disastrous results.

For less serious instances, rail burn can be remedied with grinding, which is a process similar to sanding down the top of the rail. Larger and deeper instances cannot be remedied and the only course of action available is to replace the affected section of rail.

RTD Says They Are Now Using “APTA Standards”

RTD initially explained that since May 2024, they had been using the American Public Transportation Association (APTA) standards for the track inspection and maintenance. Let’s take a closer look into what the APTA standards say…

Section 3.1a Track Inspection

Section 3.1a details the frequency and method of carrying out track inspections. The APTA standards say you can either inspect the track on foot or ride in a vehicle it at a speed that allows defects to be found.

Table 11c Rail Defect Remedial Action

Table 11c details what to do when certain rail defects are found. For “rail burn” (also known as “wheel burn”) you can easily follow the minimum remedial action to imposing 10mph “slow zones”.

What standards were RTD using previously?

On May 10th, 2023 (note year), RTD told the Colorado PUC that “the current RTD MOW Track Safety Standards 2021 is a direct adaptation of the APTA-RT-FS-S-002-02 Rail Transit Track Inspection and Maintenance Standard, Revision 1, published in 2017”.

But… in an email to GDT on July 12, 2024, RTD stated “Following the development of standard operating procedures and training materials, and upon the completion of required employee training, the standard [2021 RTD Maintenance of Way Track Safety] was fully implemented May 1, 2024.”

So which standard exactly is / was RTD using, and when did the change happen?

Section 3.1a Track Inspection (RTD’s Version)

A comparison of Section 3.1a in both standards documents reveals RTD made some edits. The weekly track inspections on foot option was removed but the frequency of vehicle based inspections has been doubled to twice weekly. Note the second sentence clumsily refers to a “walking inspection” that now doesn’t exist!

Table 11c Rail Defect Remedial Action

This table is identical in both the 2021 RTD Maintenance of Way and the APTA standards. This means that RTD has known since 2021 that “rail burn” would possibly lead to 10mph slow zones being imposed.

So what’s actually changed?

Neither APTA standards nor the 2021 RTD MOW Track Safety Standards mention conducting track inspections at an interval of 90 days, however RTD has been attributing the imposition of 10mph “slow zones” as a result of when walking inspections are carried out on each individual line. Therefore it has to be concluded that it is these walking inspections are what has directly changed (being the “enhanced inspection methodology“) and have set off the crisis.

Could RTD staff have reasonably foreseen the sudden imposition of 10mph “slow zones”?

RTD has maintained throughout that staff could not have reasonably foreseen the sudden imposition of 10mph “slow zones”.

GDT now finds this extremely hard to believe given that a track inspection methodology which mandates the “slow zones” as a response to instances of rail burn has existed within the agency since at least 2021.

Crisis Timeline

Jun 3rd, 2024 – 10mph “Slow Zones” Suddenly Appear on the E, H & R Lines

RTD suddenly and without warning imposes two 10mph “slow zones” between Colorado and Yale stations on the E / H lines and between Orchard and Dry Creek on the E / R Lines. With the coping panels project also necessitating single tracking operations between I-25 & Broadway and University stations, riders report journey times extended by 45mins, cancelled trains and a very frustrating experience all round.

Nathaniel Minor writes about the situation for Colorado Public Radio:

Jun 11th, 2024 – Bustang to the Rescue! Well sort of…

In the absence being able to provide any alternative bus transportation of their own, RTD turns to CDOT’s Bustang who help out by accepting tickets between Sky Ridge, Colorado and Denver Union stations on their south line. A 50 seater coach, 8 times a day is not a lot, but it is… something.

Jun 12th, 2024 – RTD Launches a Dedicated Light Rail Speed Restrictions Webpage

In what could be one of the few positives to come out of this whole affair, RTD launches a dedicated webpage for the light rail speed restrictions. A surprising amount of information is uploaded, including the agencies responses to the Colorado PUC (see below). The plan is clearly to try and answer everyone’s questions in one place. It’s certainly very welcome, but a growing number of GDT’s questions remain unanswered.

Jun 12th, 2024 – GDT Supplies Public comment to the RTD OSS Committee

On June 12th, 2024, GDT supplied public comment to the RTD Operations, Safety & Security Meeting including questions that we made it clear we wanted responses to. There follows in the meeting a discussion item (starts at 2:28:18) where numerous Directors including Jaime Lewis spoke about the disruption and its effect on riders.

Jun 14th, 2024 – Colorado PUC Letter to RTD

On June 14th, 2024 the Colorado Public Utilities Commission (PUC) sent a scathing letter to RTD’s Management detailing a number of performance issues such as deficient asset management, safety plans and maintenance planning procedures. The agency’s Transit Asset Management Plan (TAMP) and Public Transportation Agency Safety Plan (PTASP) were heavily criticized as “not being adequate”.

In addition, RTD’s failure to report safety issues to the PUC in a timely manner and general lack of transparency to the public were highlighted in the letter.

Jun 19th, 2024 – GDT Letter to RTD

On June 19th, 2024, GDT sent a letter to RTD requesting full answers to our questions (including those sent to the Operations, Safety & Security Committee on Jun 12th, 2024) and for the agency to take a series of actions to mitigate impact to riders.

Jun 21st, 2024 – RTD Responds to the Colorado PUC

On June 21st, 2024, RTD responded to the Colorado PUC. While the letter detailed how RTD was providing the information requested provide the information requested, it made it clear that RTD disagreed with the PUC’s assertions that the Public Transportation Agency Safety Plan (PTASP) is “not adequate”.

Disagreeing with your regulator is always an interesting situation, we await with interest the next move…

Jun 24th, 2024 – Special Board Meeting

On June 24th, 2024, a special board meeting was held to discuss the crisis. RTD staff said they had been using the APTA standards since May 2024. Just to be sure, the exact document cover features in the presentation at 21:32.

On a side note, the meeting featured a bizarre and out-of-touch speech by RTD Director Guzman (2:04:12) who suggested riders should use buses running parallel to the SE corridor (which ones?), and utilize the extended journeys to “read through that book” or “listen to that podcast”!

Jul 3rd, 2024 – 10mph “Slow Zones” Extend to County Line

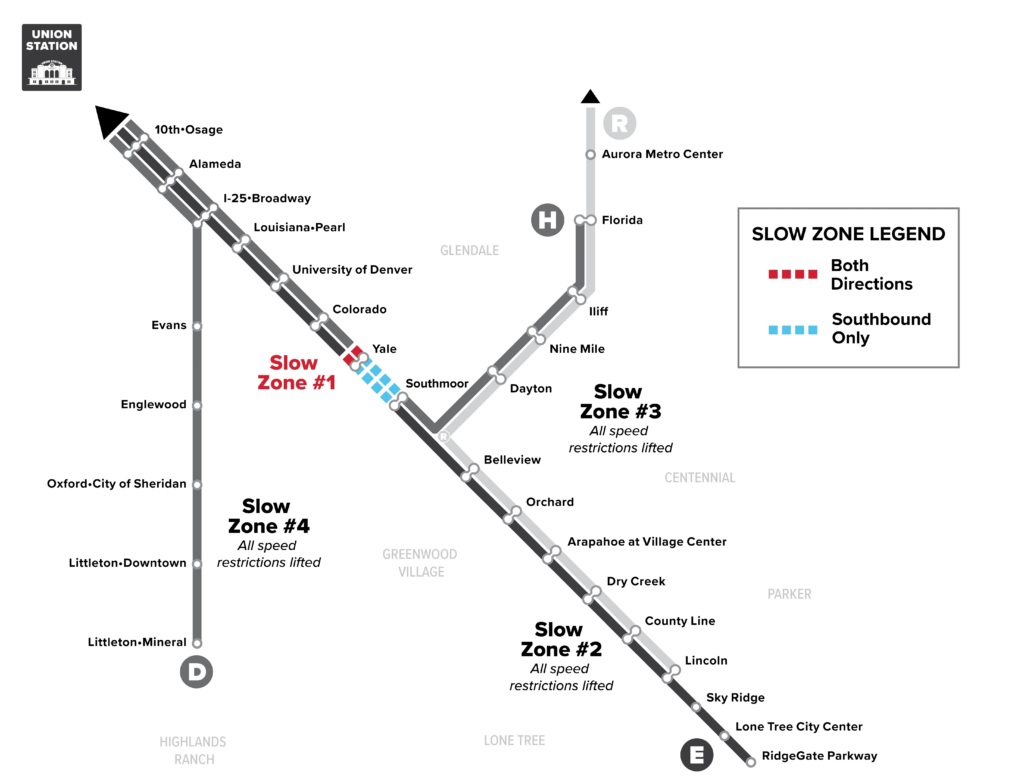

The latest map shows additional slow zones being added on the E and H Lines at County Line. The slow zone between Orchard and Dry Creek has been lifted in the northbound direction.

The accounts of delayed trains, missed appointments, people being late for work continue as RTD refuses to publish an updated (and therefore workable) schedule.

Jul 11th, 2024 – September 2024 Service Change Date Moved

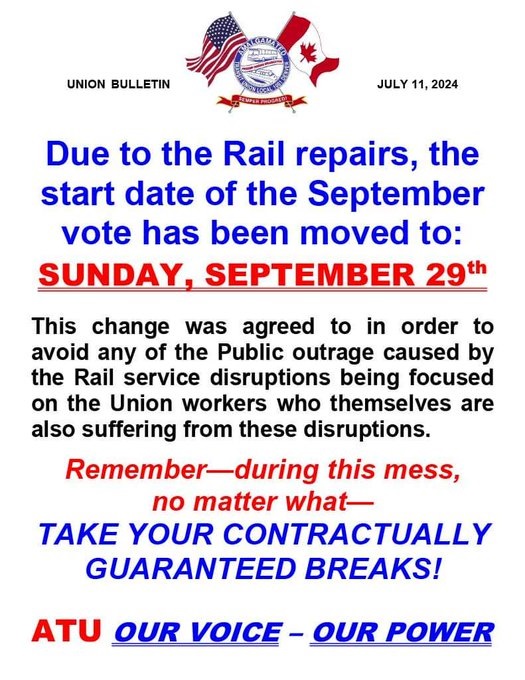

Via a bulletin from the Union, ATU1001, it emerges that RTD has delayed the start of the September 2024 service changes by two weeks from the 15th to the 29th of that month.

The Union also uses the same bulletin to remind its members that none of this situation (“mess”) is their fault and that operators should take their contractually guaranteed breaks.

Jul 12th, 2024 – RTD Responds to GDT

On July 12th, 2024, following some back and forth, RTD responded to GDT’s requests for answers. In fairness the agency made a great effort to answer us fully which is to be applauded.

The email stated that the 2021 RTD MOW Track Safety Standards took until May 1st, 2024 to implement due to the need to produce “standard operating procedures and training materials”. Three years to complete this, on the surface, does appear to be an extraordinarily long time.

Sadly the email blames two of RTD’s biggest problems for the lack of decent alternative choices for riders – the operator shortage and the ability to only change schedules three times a year.

Jul 19th, 2024 – 10mph “Slow Zones” Spread to the D Line

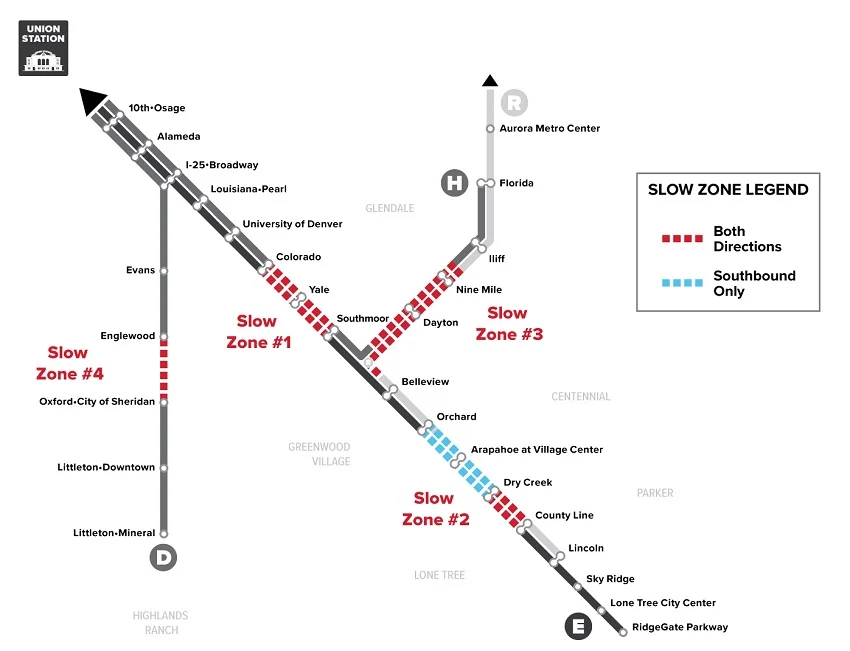

The latest map shows additional slow zones being added on the D Line and on the shared H and R tracks around Nine Mile station. No slow zones have been lifted since the last update.

The “muddling through” with an unworkable schedule continues…

Jul 22nd, 2024 – 10mph “Slow Zones” Lifted Between Orchard and Arapahoe at Village Center

The latest map shows the southbound slow zone has been lifted between Orchard and Arapahoe at Village Center.

Jul 23rd, 2024 – 10mph “Slow Zones” Spread on the D, E and R Lines…

Yesterday’s improvements are cancelled out with the slow zones on the D, E and R lines increasing in length.

Jul 24th, 2024 – One southbound 10mph “Slow Zone” Eliminated on the E and R Lines…

Arapahoe at Village Center to Orchard station is now back at full speed!

Aug 15th, 2024 – 10mph “Slow Zones” Creep North on the D, E and H Lines…

It’s a case of one step forward but two steps back this week as while the Northbound slow zone between Dry Creek and County line has been lifted, Evans and University of Denver join the list of stations affected.

Aug 27th 2024 – RTD GM & CEO Comments

On August 27th, 2024, at a public event, the RTD GM & CEO made comments to transportation journalist Nate Minor that basically said that the press, riders and advocates were basically overreacting to the situation on light rail.
